Part 2 examined the outer execution structures of an agent system:

  • Direct
  • Pipeline
  • Router
  • State Machine
  • DAG

Those structures describe how work may move through the system. They do not fully determine what happens inside one node.

Suppose a state machine enters RESEARCH. The node may still need to decide whether to:

  • search the official documentation
  • query an internal source
  • rewrite a failed query
  • inspect an API response
  • ask the user for missing information
  • stop because the evidence is sufficient
  • escalate because the task cannot be completed safely

This is the decision-and-planning layer.

The central question is:

How much of the next action should be predetermined, planned in advance, revised during execution, or selected from a formal procedure?

This article compares five useful approaches:

  1. fixed decision logic
  2. bounded ReAct
  3. Plan-and-Execute
  4. adaptive planning and replanning
  5. hierarchical decomposition, including formal HTN planning

It also separates two concerns that are often mixed into the same list:

  • Goals define the desired outcome.
  • Policies constrain which actions are permitted.

Goals and policies shape every strategy. They are not peer planning algorithms.

Execution structure and decision strategy are different layers

A state machine may define the outer route:

START
  -> PLAN
  -> RESEARCH
  -> VERIFY
  -> ANSWER
  -> END

Inside RESEARCH, the system may use one of several decision strategies.

Fixed logic

Search official source
  -> Extract required fields
  -> Return structured result

The application decides the next step.

Bounded ReAct

Read goal and current state
  -> Select an allowed action
  -> Execute tool
  -> Inspect normalised observation
  -> Update progress
  -> Select again or stop

The next action depends on the latest observation, but only within explicit limits.

Plan-and-Execute

Create a structured plan
  -> Select the current step
  -> Execute the step
  -> Record the result
  -> Continue, repair, or replan

The system establishes a global plan before performing the individual steps.

These strategies can live inside the same outer workflow. A state machine can call a planner, launch a bounded ReAct executor for one step, and invoke a verifier before allowing the next transition.

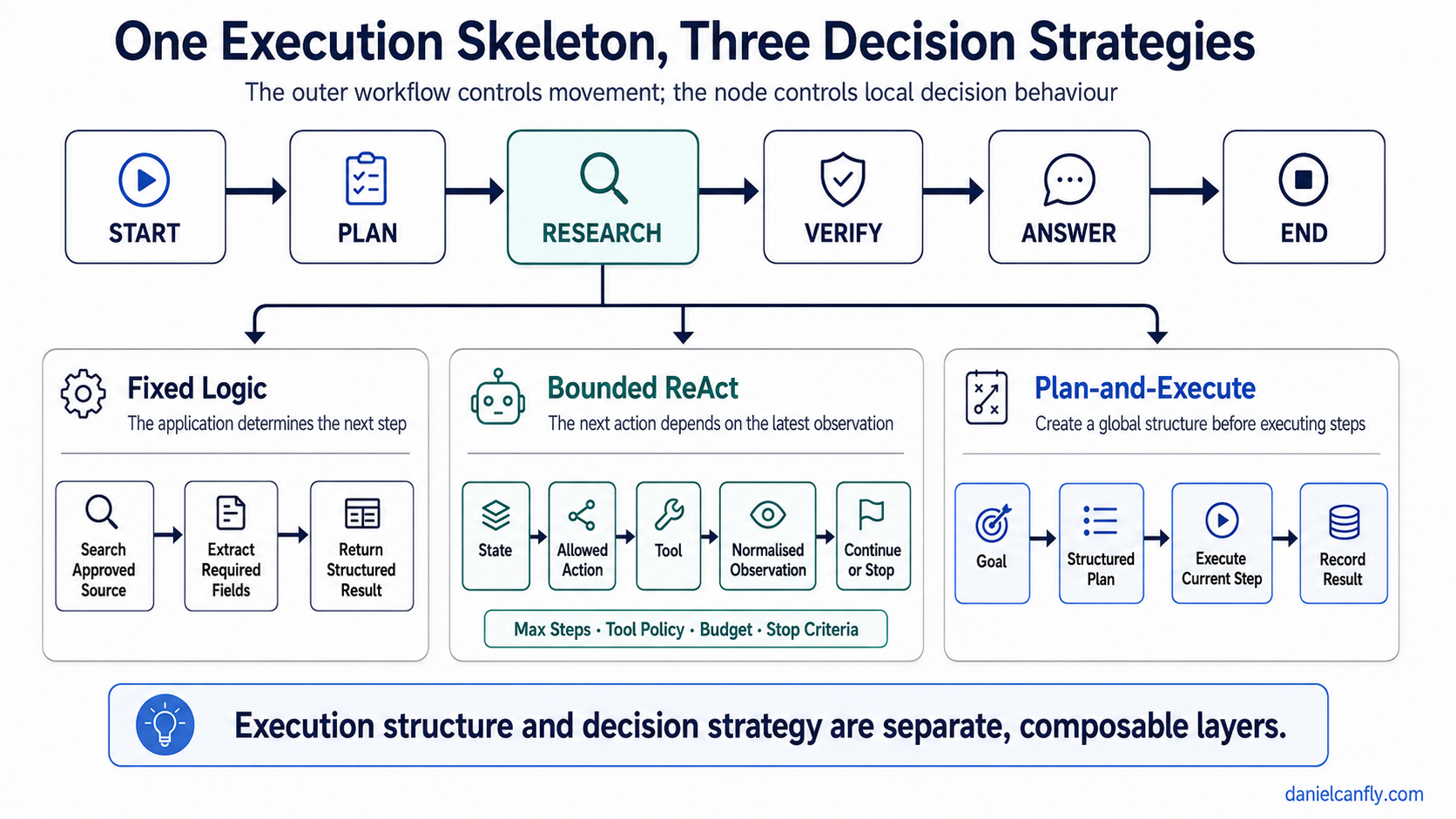

Figure 3-1 — One Execution Skeleton with Three Decision Strategies

Figure 3-1|One Execution Skeleton with Three Decision Strategies
A single RESEARCH node inside an outer state machine can switch between fixed logic, bounded ReAct, and Plan-and-Execute depending on what the step requires.

A more precise map of the planning layer

ConcernPrimary questionTypical mechanism
Fixed decision logicIs the next step already known?Rules, application code, fixed workflow
Reactive action selectionDoes the next action depend on the latest observation?Bounded ReAct or another closed-loop policy
Explicit planningShould the task be decomposed before execution?Plan-and-Execute
ReplanningHas new evidence invalidated the remaining plan?Triggered adaptive planning
Hierarchical decompositionDoes the goal contain several levels of subgoals?Hierarchical planner
Formal procedural decompositionIs there a reusable domain model of valid decompositions?HTN planner
Plan validationIs the proposed plan feasible and acceptable?Verifier, simulator, solver, policy checks
GovernanceWhich actions are allowed and how much may they cost?Policy layer, budget, approval, audit

This map is intentionally layered. It avoids treating every named mechanism as a complete agent architecture.

Fixed decision logic: keep deterministic work deterministic

Fixed decision logic means that the application already knows the next step.

Classify
  -> Retrieve
  -> Generate
  -> Verify

The model may perform work inside a step, but it does not freely redesign the sequence.

Good uses

  • document ingestion
  • fixed extraction and transformation
  • stable RAG stages
  • known approval procedures
  • deterministic validation
  • compliance-sensitive operations with established rules
  • tasks where every request requires the same sequence

Strengths

  • predictable cost and latency
  • straightforward tests
  • clear permissions
  • reproducible execution
  • simple failure attribution
  • low risk of loops

Limitation

A fixed flow cannot react to an unmodelled situation unless the application already contains a branch for it.

If an official page disappears, the system must have a defined response:

  • switch to another approved source
  • mark the field unavailable
  • ask for credentials
  • stop with a typed failure
  • escalate for human handling

Fixed logic is not an immature design. It is often the correct outer boundary for a production agent. Autonomy should be introduced only where predetermined rules are genuinely insufficient.

ReAct: choose the next action from the latest observation

The original ReAct method interleaves reasoning traces with task-specific actions and observations. In engineering terms, the useful idea is a closed loop:

Current goal and state
  -> Choose action
  -> Act in an environment
  -> Receive observation
  -> Update the next decision

The method does not require one particular workflow engine or node boundary. In production, teams often place a ReAct-style loop inside a bounded executor node so that local flexibility does not control the entire application.

Good uses

  • web and documentation research
  • debugging
  • browser interaction
  • API exploration
  • file-system investigation
  • operating an unfamiliar interface
  • tasks where the next useful action cannot be known before seeing the result

Example

The goal is to confirm a product’s current billing rules.

Action:
Open the official pricing page

Observation:
Only annual prices are visible

Action:
Open the official billing documentation

Observation:
Monthly billing is available only for selected plans

Action:
Check the official FAQ for plan-level exceptions

The value comes from adapting to observations instead of following a prewritten list of URLs.

ReAct is local adaptation, not global reliability

A raw action-observation loop does not automatically provide:

  • a measurable definition of progress
  • a reliable completion condition
  • permission enforcement
  • cost control
  • duplicate-action detection
  • durable state
  • recovery after interruption
  • evidence quality
  • acceptance of the final result

Those belong to the production architecture around the loop.

Why ReAct loops without making progress

A typical failure trajectory looks active but repeats the same state:

Search query A
  -> insufficient evidence
Search query B
  -> insufficient evidence
Search query A again
  -> open a previously rejected page
Search query B again

Common causes include:

No progress model

The executor knows that it should continue, but not which requirements remain unresolved.

Unstructured observations

Long tool outputs are appended to context without extracting:

  • source identity
  • relevant facts
  • unresolved questions
  • conflicts
  • failure reason
  • suggested next action

No duplicate detection

The runtime does not detect repeated:

  • queries
  • URLs
  • tool calls
  • parameters
  • error conditions
  • equivalent actions expressed in different words

Vague completion criteria

“Keep researching until enough information is found” is not testable.

A stronger condition is:

Complete when:
- every required comparison field is filled or marked unavailable
- every factual claim has an approved source
- all material conflicts are recorded
- no critical verifier failure remains

Excessive tool freedom

A large tool catalogue without permissions, costs, priorities, or call limits creates exploration noise rather than capability.

A production ReAct loop needs explicit contracts

A bounded executor should receive:

  • the current step objective
  • allowed tools
  • available inputs
  • completion criteria
  • prohibited actions
  • remaining budget
  • maximum actions
  • current progress state
  • escalation policy

Each tool should return a structured observation rather than an arbitrary text blob.

Example:

{
  "tool": "official_docs_search",
  "status": "success",
  "source": "https://example.com/docs",
  "facts": [
    {"field": "monthly_billing", "value": "selected_plans_only"}
  ],
  "unresolved": ["which plans support monthly billing"],
  "retryable": false
}

The loop should evaluate three outcomes after each observation:

  1. complete: the step contract is satisfied
  2. continue: another allowed action is justified
  3. escalate: the executor cannot finish within its authority or budget

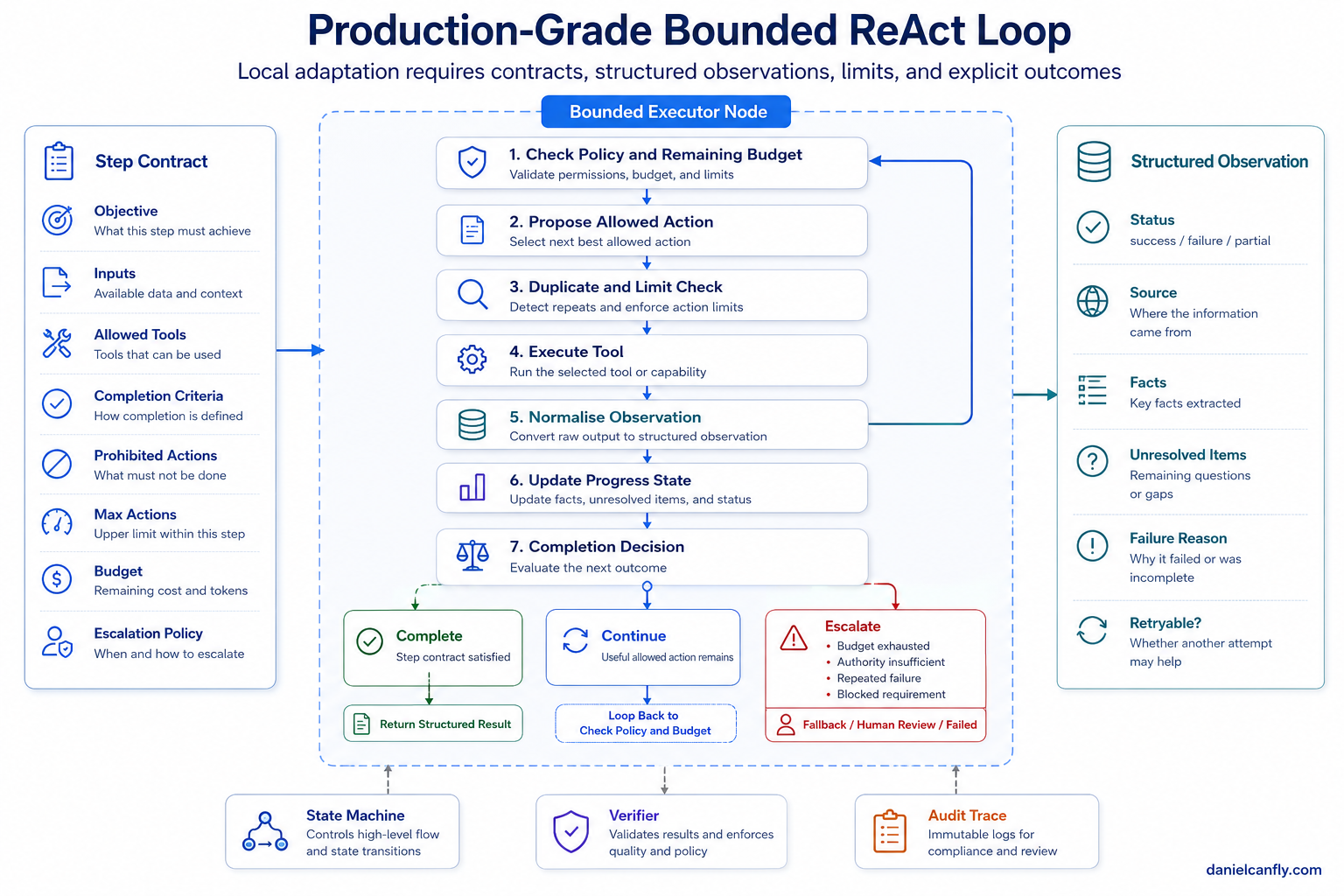

Figure 3-2 — Production ReAct Loop with Explicit Step Contract

Figure 3-2|Production ReAct Loop with Explicit Step Contract
A bounded executor must receive step objective, allowed tools, completion criteria, budget, and escalation policy. After every observation it judges complete, continue, or escalate.

Plan-and-Execute: establish the global structure before acting

Plan-and-Execute is best treated as an engineering pattern family, not one canonical algorithm with one universal implementation.

Its defining rhythm is:

Goal
  -> Produce an explicit plan
  -> Execute plan steps
  -> Integrate the results

Related research separates planning or reasoning from tool observations in different ways. Plan-and-Solve prompting decomposes a problem before solving its subtasks. ReWOO separates a planner-like reasoning stage from workers that obtain tool evidence and a solver that combines the results. These works are related, but they should not be presented as one identical architecture.

Good uses

  • long-form research
  • multi-document review
  • migration planning
  • large code changes
  • market analysis
  • project work with many requirements
  • tasks with ordering or dependency constraints
  • tasks that must expose progress

Strengths

Global coverage

The planner can enumerate all required dimensions before execution begins.

Trackable progress

The system can distinguish:

  • pending
  • ready
  • running
  • blocked
  • completed
  • failed
  • skipped

Clear delegation

Independent steps may be assigned to different tools, workers, or DAG branches.

Better integration planning

The expected output of each step can be designed to support the final synthesis.

Central weakness

A polished plan may still be infeasible, incomplete, or based on a false premise.

If a planner guesses instead of reading the real input, the executor may efficiently complete the wrong task. Plan generation therefore does not replace source acquisition, constraint checking, or verification.

A plan must be executable, not ceremonial

This is not an executable plan:

1. Research the topic
2. Analyse the information
3. Write the answer

It merely restates the task.

A production step should include a contract such as:

FieldPurpose
Step IDStable identifier
ObjectiveOutcome this step must achieve
InputsRequired state and artefacts
DependenciesSteps that must finish first
Allowed toolsCapabilities available to the executor
Expected outputStructured result to produce
Completion criteriaObservable acceptance condition
Failure policyRetry, fallback, block, replan, or stop
BudgetTime, tokens, calls, or money
StatusCurrent lifecycle state
Provenance requirementsEvidence that must accompany the result

Example:

Step ID:
S3

Objective:
Collect official pricing information for every candidate

Dependencies:
S1 evaluation criteria completed
S2 candidate list approved

Allowed tools:
Official web search
Browser

Expected output:
Structured pricing table with source URL and access date

Completion criteria:
Every candidate has a documented price
or an explicit unavailable / undisclosed status

Failure policy:
Try official pricing page
then official documentation
then official announcement
otherwise mark unavailable

Budget:
6 tool calls
8 minutes

This gives the executor a bounded assignment and the verifier an acceptance contract.

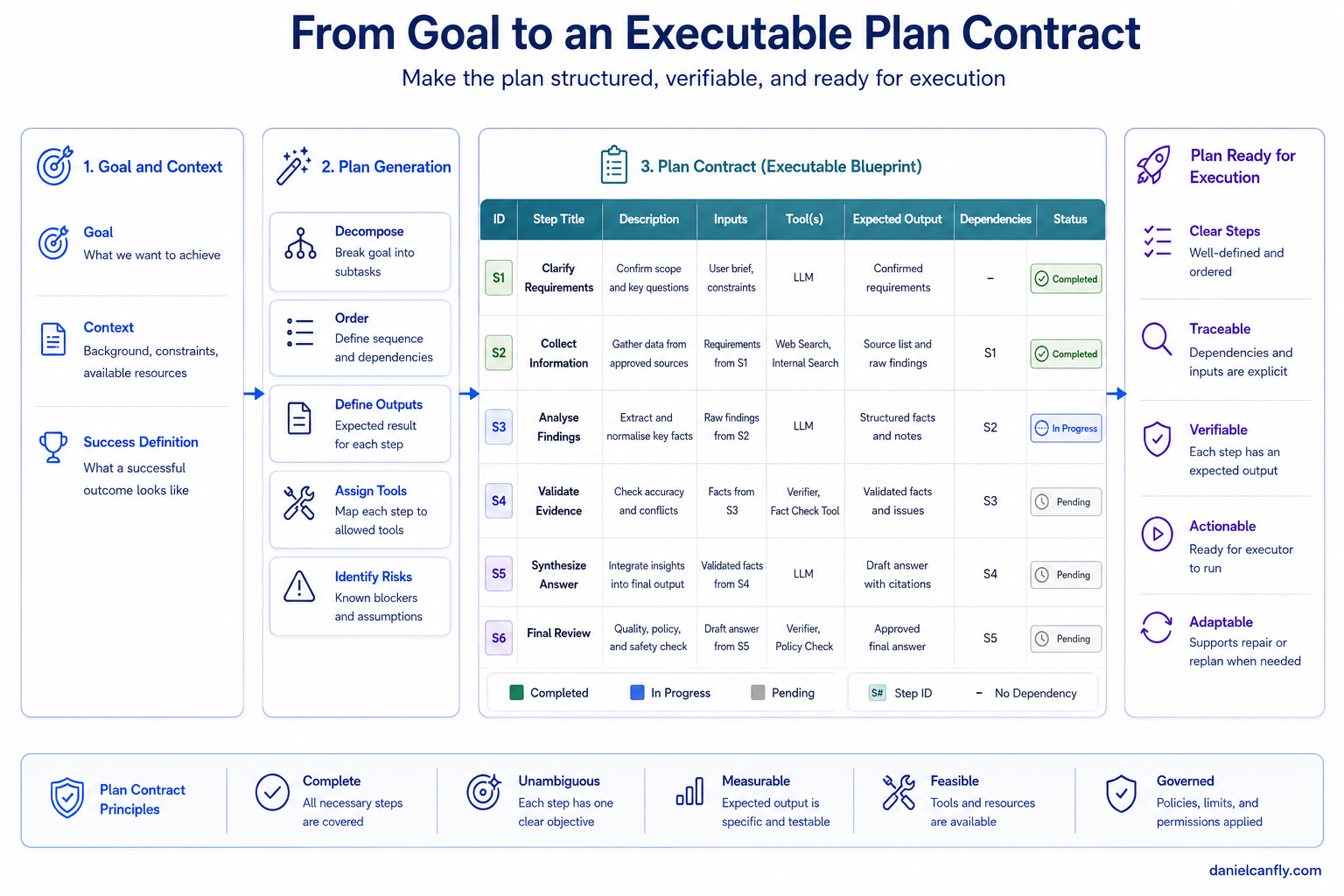

Figure 3-3 — Executable Plan Contract

Figure 3-3|Executable Plan Contract
A plan step cannot be just a task name. It must carry objective, dependencies, allowed tools, expected output, completion criteria, failure policy, and budget.

Plan validation: a plan is a proposal, not proof

Language models can produce plausible-looking plans that violate preconditions, omit required effects, or invent actions unavailable in the environment.

Validation strength should match the task.

Natural-language review

Useful for low-risk work where the main concern is missing requirements or weak sequencing.

Deterministic checks

Validate:

  • required fields
  • dependency references
  • cycle-free step dependencies
  • permitted tools
  • budget totals
  • known preconditions
  • output schema

Simulation or dry run

Test the plan against a model of the environment before performing irreversible actions.

External planner or solver

When the domain has formal actions, preconditions, effects, and constraints, a classical planner or solver may provide stronger guarantees than free-form generation. LLM+P, for example, converts a natural-language problem into a planning representation and delegates plan search to a classical planner.

The lesson is not that every business workflow needs PDDL. It is that fluent generation is not the same as plan validity.

Adaptive planning: change the remaining plan when reality changes

A static plan assumes that its premises remain valid. An adaptive planner inspects execution feedback and revises the remaining work when a material assumption fails.

Create plan
  -> Execute one step
  -> Inspect result
  -> Is the remaining plan still valid?
       yes -> continue
       no  -> repair locally or create a revised plan

Adaptive planning should not mean “rewrite the whole plan after every step”. It needs explicit triggers and bounded authority.

Valid replan triggers

  • a critical premise is false
  • required data is unavailable
  • a dependency changed
  • the user’s goal or constraint changed
  • a verifier rejected the result
  • a tool or capability is unavailable
  • the remaining budget cannot support the plan
  • repeated local repair failed
  • a new high-priority risk was discovered

Local repair versus global replan

Not every failure requires replanning.

Use local repair when:

  • the objective remains valid
  • only one step implementation failed
  • an approved fallback can satisfy the same contract
  • dependencies and later steps remain unchanged

Use replanning when:

  • a premise affecting several steps changed
  • the original decomposition is no longer valid
  • the deliverable or constraint changed
  • later dependencies must be rewritten
  • a new approval or policy boundary appears

Preserve valid completed work

A revised plan should not silently discard work that remains correct.

Example:

Plan v1

Completed:
S1 Define evaluation criteria
S2 Select candidate frameworks

Blocked:
S3 Collect official pricing

A replan may produce:

Plan v2

Preserved:
S1 Define evaluation criteria
S2 Select candidate frameworks

Revised:
S3A Search official documentation
S3B Search official announcements
S3C Mark undisclosed pricing explicitly

Unchanged:
S4 Compare architecture
S5 Produce recommendation

Versioning requirements

Record:

  • immutable original goal
  • current plan version
  • previous plan version
  • replan trigger
  • plan diff
  • preserved steps
  • invalidated steps
  • new dependencies
  • replan count
  • verifier decision
  • actor or model that approved the change

Adaptive planning research such as AdaPlanner demonstrates feedback-driven refinement. Production governance adds explicit plan versions, limits, and auditability so that replanning itself does not become an uncontrolled loop.

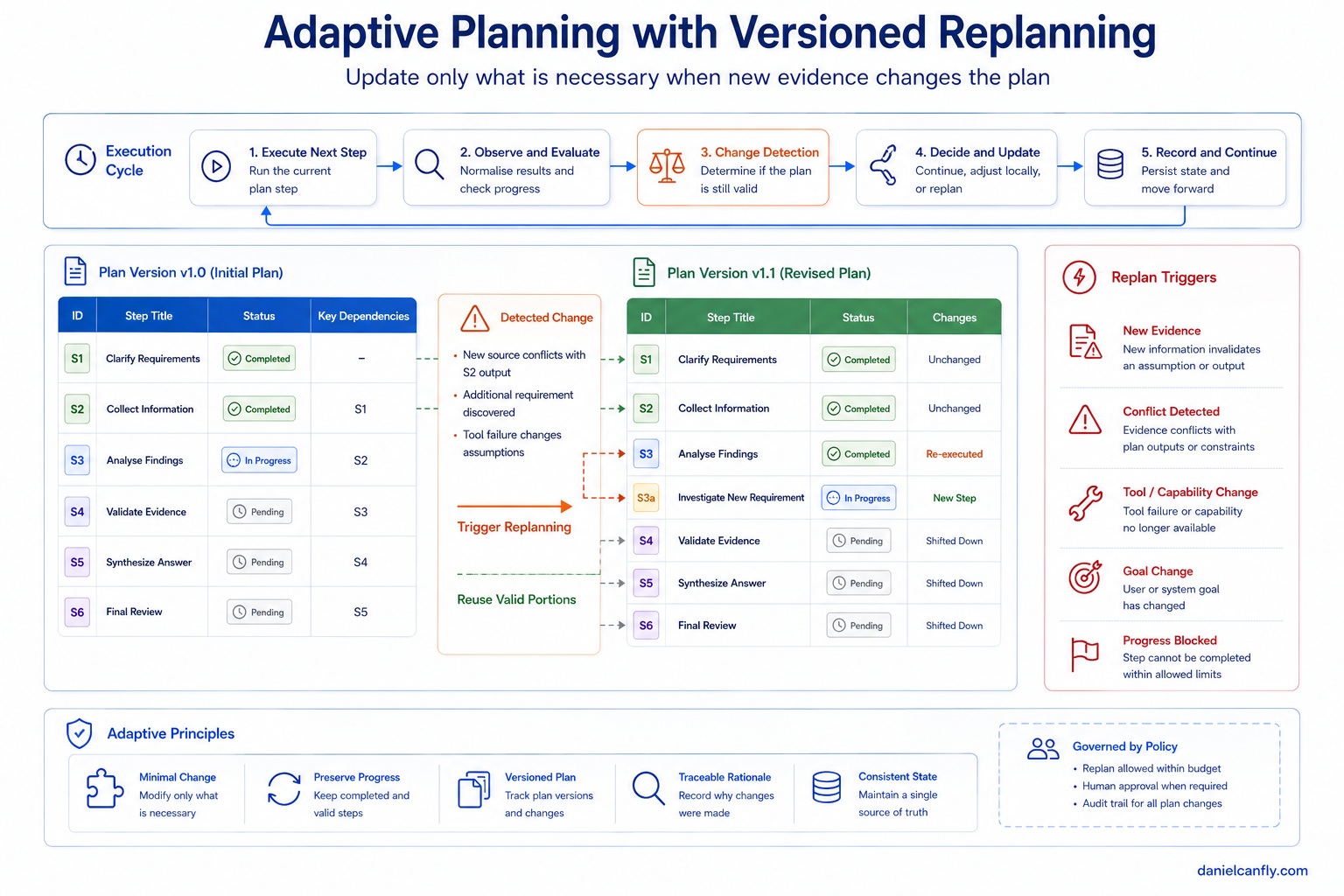

Figure 3-4 — Adaptive Planning with Versions

Figure 3-4|Adaptive Planning with Versions
Replanning is triggered by explicit signals. A revised plan preserves valid completed work and records the plan diff, replan count, and preserved steps.

Hierarchical planning: decompose goals at several levels

A flat plan becomes difficult to manage when a goal contains several independent areas of work.

Hierarchical planning separates levels:

Main goal
  -> Subgoal A
       -> Task A1
       -> Task A2
  -> Subgoal B
       -> Task B1
       -> Task B2
  -> Subgoal C
       -> Task C1

Example:

Produce market recommendation
  -> Analyse market
       -> estimate size
       -> identify growth drivers
  -> Analyse competitors
       -> collect pricing
       -> compare features
       -> review positioning
  -> Produce recommendation
       -> synthesise findings
       -> identify risks
       -> recommend action

Benefits

  • the upper level tracks outcomes rather than tool calls
  • subgoals can be delegated
  • local failures can be isolated
  • context can be scoped to the worker
  • independent branches can become DAG nodes

Risks

  • duplicated work across subgoals
  • inconsistent assumptions
  • loss of intent during hand-offs
  • incompatible output formats
  • completion of every subtask without completion of the parent goal

Hierarchical decomposition therefore needs:

  • parent and child completion contracts
  • shared facts and terminology
  • source provenance
  • dependency management
  • integration ownership
  • cross-subgoal verification

HTN: formal decomposition with domain methods

Hierarchical Task Network planning is a formal planning approach. It refines compound tasks into lower-level task networks until executable primitive tasks remain.

Core concepts include:

Compound task

A task that requires decomposition.

Process customer refund

Method

A domain-specific decomposition that may apply when its conditions hold.

Standard refund method:
  verify order
  check eligibility
  calculate amount
  execute refund
  notify customer

Primitive task

An action that the execution system can perform directly.

Query order database
Create approval request
Issue refund
Send confirmation

The important distinction is not simply “humans wrote the plan”. HTN planning relies on domain knowledge encoded as tasks, methods, constraints, and operators. That domain model is often authored and governed by experts, but methods may also be generated or learned and then validated.

When HTN is useful

  • established operational procedures
  • logistics and fulfilment
  • customer service processes
  • IT operations
  • regulated approvals
  • reusable domain-specific decompositions
  • environments where allowed procedures matter more than open-ended creativity

Strengths

  • auditable decomposition
  • reusable methods
  • strong fit with domain rules
  • controllable search space
  • consistent execution structure

Limits

  • the domain model is expensive to build and maintain
  • unmodelled tasks remain difficult
  • stale methods reproduce stale behaviour
  • several applicable methods require selection
  • formal correctness still depends on the accuracy of the domain model

HTN and LLMs can be combined

A practical arrangement is:

LLM:
Interpret the natural-language request
  -> map it to a known task and extract parameters

HTN planner:
Select applicable methods
  -> decompose into primitive tasks

Execution system:
Run permitted primitive tasks

LLM:
Handle language-heavy steps and explain results

The LLM handles ambiguity. The HTN model constrains procedure.

Goals and policies are cross-cutting, not peer strategies

The previous categories describe how decisions or plans are produced. Goals and policies operate across all of them.

Goal

A goal defines the desired state or acceptance condition.

A strong goal is measurable:

All target tests pass
Full test suite passes
Lint passes
Build succeeds
No unrelated files changed

A weak goal is open-ended:

Improve the repository

Fixed logic, ReAct, Plan-and-Execute, adaptive planning, and HTN all need goals.

Policy

A policy defines which proposed actions may proceed.

Proposed action
  -> Policy check
       -> allowed -> execute
       -> approval required -> pause
       -> denied -> reject or use fallback

Policies may cover:

  • tools
  • permissions
  • data access
  • cost
  • risk
  • privacy
  • network access
  • reversibility
  • human approval

Important policy enforcement should live in application or infrastructure controls, not only in a prompt.

Examples:

  • read-only database credentials
  • scoped API tokens
  • network restrictions
  • sandboxed file access
  • tool allowlists
  • spending limits
  • approval gates

The agent should not be the sole authority deciding whether its own safety rule applies.

Comparing the main decision strategies

DimensionFixed logicBounded ReActPlan-and-ExecuteAdaptive planningHTN
Main rhythmFollow predetermined rulesDecide after observationsPlan first, then executePlan, execute, and revise when triggeredRefine tasks through domain methods
Global viewEncoded by developersUsually limitedStrongerStronger and updateableEncoded in the task-method model
Local adaptationLow unless branches existHigh within limitsExecutor-dependentHigh when repair or replan is allowedLimited to available methods and execution feedback
PredictabilityHighLowerMediumMedium to lowerHigh within the modelled domain
Main riskBrittlenessLooping and local myopiaWrong plan executed efficientlyReplanning drift and costStale or incomplete domain model
Best fitStable tasksUncertain tool interactionLong multi-requirement tasksLong tasks in changing environmentsEstablished reusable procedures
Required controlsTests and typed failuresLimits, progress, policy, stop criteriaPlan schema and plan validationVersioning, triggers, diff, replan limitMethod governance and domain validation

These are defaults, not universal scores. A tightly bounded ReAct executor may be more predictable than a weakly specified static plan.

The production hybrid: Planner, bounded Executor, Verifier, and Replanner

A robust architecture often combines the methods:

User goal
  -> Planner
  -> Versioned plan store
  -> State machine selects ready step
  -> Bounded executor
       -> uses fixed logic or ReAct as appropriate
  -> Verifier
       -> pass
       -> local repair
       -> replan
       -> fail or escalate

Planner responsibilities

  • understand the complete goal
  • create subgoals and steps
  • define dependencies
  • assign budgets
  • define outputs and completion criteria
  • identify approval and policy boundaries

Executor responsibilities

  • execute one step contract
  • use only allowed tools
  • adapt locally to observations
  • normalise results
  • update progress
  • report blockers rather than silently changing the goal

Verifier responsibilities

  • check the step contract
  • validate evidence and output schema
  • detect missing requirements
  • distinguish local repair from global replan
  • approve or reject completion

Replanner responsibilities

  • respond only to valid triggers
  • preserve valid completed work
  • update the remaining dependencies
  • produce a plan diff
  • respect the replan limit

State machine responsibilities

  • persist progress
  • control legal transitions
  • manage retries and waiting
  • enforce terminal states
  • coordinate approval

Policy layer responsibilities

  • authorise tools and data
  • limit cost and time
  • intercept high-impact actions
  • require human approval
  • create an audit trail

Figure 3-5 — Production Planning Architecture

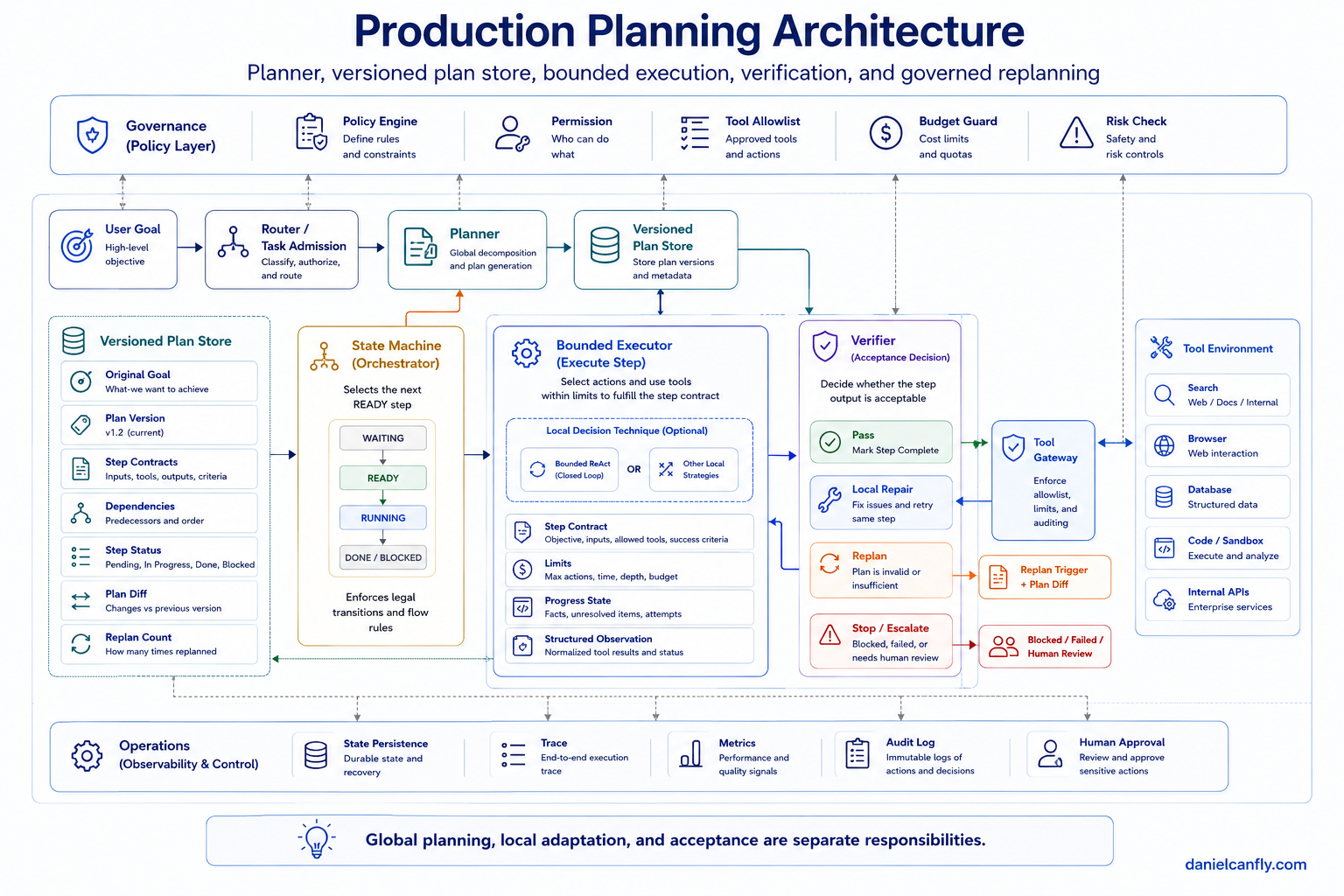

Figure 3-5|Production Planning Architecture
The Planner produces a versioned plan, the state machine selects the ready step, a bounded executor runs it, the Verifier accepts or rejects, and the Replanner rewrites remaining work only when a real trigger fires.

How to choose a strategy

Start with the least flexible mechanism that can reliably complete the task.

Use fixed logic when

  • the next step is known
  • the environment is stable
  • the same contract applies to every request
  • predictability matters more than adaptation

Add bounded ReAct when

  • the next useful action depends on the latest tool result
  • the environment is difficult to enumerate
  • local exploration is necessary
  • completion can still be verified

Add Plan-and-Execute when

  • the task has many requirements
  • omissions are costly
  • progress must be visible
  • dependencies or delegation matter

Add adaptive replanning when

  • premises may change during execution
  • a static plan can become invalid
  • local repair is sometimes insufficient
  • the system can identify material replan triggers

Use hierarchical decomposition when

  • a flat plan is too large
  • subgoals have distinct owners or contexts
  • parent and child completion can be defined

Use HTN when

  • the domain has reusable, governed procedures
  • valid decomposition methods can be modelled
  • consistency and auditability are central

Use an external planner or solver when

  • preconditions and effects are formal
  • feasibility matters more than fluent explanation
  • constraints are too important to leave to free-form generation
  • a valid or optimal plan is required

Common anti-patterns

Planning every task

A translation or fixed extraction does not need a five-step plan.

Treating the plan as ground truth

A generated plan is a hypothesis about how to complete the work.

ReAct without a step contract

The executor explores tools without knowing what output it must produce.

Replanning after every observation

The system spends more time rewriting plans than executing them.

Global replan for a local failure

One unavailable endpoint causes the entire plan to be discarded.

Replanning without versions

The previous plan disappears, making drift and repeated work invisible.

Hierarchy without integration ownership

Every subgoal is complete, but no one owns the final outcome.

Calling every goal-directed loop a separate architecture

Every useful agent pursues some goal. The differentiator is how action selection, planning, verification, and control are implemented.

Safety rules only in prompts

The model is asked not to use a capability that the runtime still exposes without restriction.

Planner and executor duplicate the same work

The planner specifies a research strategy; the executor ignores it and redesigns the task from the beginning.

Refusing to admit an unsatisfied task

The correct terminal result may be:

  • unavailable
  • unsupported
  • blocked
  • partial
  • requires human action

Another planning round cannot create missing evidence or permissions.

What production planning should record

RecordWhy it matters
Original goalPrevents drift
Goal versionRecords authorised goal changes
Current plan versionIdentifies the active plan
Plan diffExplains what changed
Replan triggerJustifies the revision
Step contractDefines execution and acceptance
Step dependencyControls readiness
Step statusTracks progress
Tool calls and observationsRecords actual execution
Evidence and provenanceSupports verification
Retry countBounds local repair
Replan countBounds global revision
Remaining budgetControls cost
Policy decisionRecords permission and risk checks
Verifier resultAccepts or rejects completion
Terminal outcomeCompleted, partial, blocked, failed, or cancelled

Without these records, a long task is a long conversation rather than a manageable process.

Complete example: researching agent frameworks

The goal is:

Compare three agent frameworks and recommend one for a production RAG system.

Router

Select the research workflow instead of direct question answering.

Planner

Create:

S1 Define evaluation criteria
S2 Confirm candidate frameworks
S3 Collect official architecture information
S4 Compare state and persistence
S5 Compare observability and testing
S6 Compare tool and multi-agent support
S7 Evaluate risks and operational fit
S8 Produce recommendation

Each step receives a contract, budget, and completion criteria.

Executor

For S3, a bounded ReAct executor may:

Open official architecture documentation
  -> required field missing
Open official persistence documentation
  -> record capability and version
Inspect official repository
  -> extract structured evidence
Stop when all fields are documented or explicitly unknown

Verifier

Check:

  • every material claim uses an official source
  • every comparison field is covered
  • missing information is marked unknown
  • version dates are not mixed
  • the recommendation follows the criteria

Adaptive replan

One framework does not publish pricing or a required technical detail.

The replanner changes only the remaining work:

Replace inferred field with:
- publicly documented capabilities
- explicitly marked unknowns
- no unsupported estimate

Synthesis

Integrate the verified results and produce the recommendation.

This is not pure ReAct and not pure Plan-and-Execute. It is a governed composition of routing, planning, bounded action selection, verification, state management, and triggered replanning.

Conclusion

The planning layer is easier to understand when its mechanisms are separated:

  • Fixed decision logic keeps known work deterministic.
  • Bounded ReAct adapts the next local action to the latest observation.
  • Plan-and-Execute creates an explicit global structure before execution.
  • Adaptive planning revises remaining work after a material trigger.
  • Hierarchical planning organises large goals into several levels.
  • HTN uses a formal domain model to refine compound tasks into executable tasks.
  • Plan verification determines whether a plausible plan is actually acceptable.
  • Goals and policies define outcomes and boundaries across every strategy.

The production objective is not maximum planning freedom. It is deliberate placement of flexibility:

fixed outer control
  + explicit plan where global coverage matters
  + bounded local adaptation where observations matter
  + verification before acceptance
  + versioned replanning only when reality invalidates the plan

Part 4 moves from planning to search:

When several candidate solutions are possible, how should an agent explore, compare, prune, and select them?
